coil car for steel handling,steel coil cart

A coil car is a powered carriage on floor rails that lifts, holds, and transports steel coils between stations with precise positioning. It handles the final few meters of movement where overhead cranes are inefficient, ensuring coils are placed exactly at the correct height and location for downstream equipment like wrapping machines, strapping stations, or decoilers.

Overview

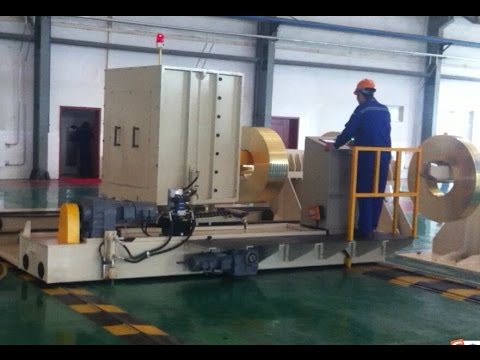

The video evidence shows a factory environment with a large steel coil rack, yellow safety barriers, and a blue-uniformed worker operating a control platform. The primary equipment consists of a light gray and beige cabinet with blue motor components and yellow drive or clamping parts. In the footage, a golden steel coil is pushed horizontally and fixed on a central rotating support arm, with a red warning light illuminated. The coil is then positioned, and the machine remains stationary while the operator observes.

The video does not show the continuous movement of the car along the floor rails, nor does it display the lifting of the V-cradle or the clamping arms securing the coil during transport. Specific values for rated capacity, maximum coil diameter, drive power, cycle time, or certification marks are not visible in the provided media.

Why use a coil car instead of a crane?

An overhead crane is suitable for moving coils across a bay, but it is not designed for the fine positioning required to load a wrapping ring, a mandrel, or a decoiler. Every crane placement typically involves a slinger and a swinging load. A coil car eliminates this variability by running on fixed floor rails, ensuring it always stops in the same place and at the same height. This precision allows downstream stations to start processing immediately without waiting for manual adjustments.

Furthermore, using a coil car removes the crane from the immediate feeding cycle. While the coil car is busy feeding a packing or strapping station, the overhead crane is free to bring in the next raw coil or remove a finished one.

How a coil car handles a coil

The operation of a coil car follows a defined sequence to ensure safety and precision. First, the overhead crane places the coil, with its eye horizontal, onto the car’s V-shaped cradle at the designated loading point. Second, side clamping arms close in to hold the coil securely, preventing it from rolling during travel. Third, the car runs along its floor track to the target station. A red warning lamp is lit while the sequence is active; it signals machine status rather than one specific motion.

Fourth, the cradle lifts the coil to match the station’s center height, allowing the coil to be transferred onto the station’s rollers, saddle, or mandrel. Finally, the car lowers its cradle and returns to the loading position for the next coil, or waits to transport a wrapped coil to an outfeed rack. The operator controls this process from a platform behind a yellow safety railing, with yellow-black floor markings clearly defining the travel zone.

Sizing the lift and capacity

Two primary factors determine the design of a coil car: the lift stroke required and the load capacity. The lift stroke is dictated by the smallest coil in the production range and the center height of the destination station. The car must lift the coil from its lowest position on the cradle up to the station’s center height.

For example, if a station has a center height of 1,100 mm and the lowered cradle top is at 300 mm, a coil with a 1,000 mm outer diameter (OD) has its center at 800 mm (300 mm + 500 mm radius). The lift needed is 300 mm (1,100 mm – 800 mm). For a larger coil with a 1,600 mm OD, the center is at 1,100 mm, requiring zero lift to reach center height, but additional clearance is still needed for the bore to clear the mandrel. Therefore, the total stroke is calculated as the lift for the smallest coil plus a fixed clearance determined by the layout drawing.

Coil Center on lowered car Lift needed
1,000 mm OD 300 + 500 = 800 mm 1,100 − 800 = 300 mm
1,600 mm OD 300 + 800 = 1,100 mm 0 mm to center, plus clearance

Capacity sizing involves selecting a car that can handle the heaviest coil with a safety margin. An illustrative calculation uses a 1.25 factor: for a 10-ton coil, the rated capacity would be 12.5 tons. This factor is an engineering convention, confirmed per project against the actual maximum weight.

One car or two: line layout considerations

When a production line features two coil stations, such as a wrapping station and a strapping station located side by side, there are two configuration options. One option is to use a single coil car that shuttles back and forth between both stations. The alternative is to install two separate coil cars, one dedicated to each station.

For dual-station setups the usual recommendation is two coil cars. This configuration allows each station to have its own independent feed. Consequently, one coil can be wrapped while the next is simultaneously being loaded. The choice between one or two cars depends on the specific layout, cycle time targets, and budget constraints, which must be confirmed per project.

Options and customizations

Standard coil cars provide the core functions of lifting, clamping, and transporting. However, several options can be added to address specific operational needs. A V-cradle can be lined with wear-resistant material to protect the edges of the steel coils from damage. For narrow or slit coils that may be unstable, additional clamping arms can be installed to prevent tipping.

A turntable can be integrated into the car to rotate the coil before placing it, which is particularly useful for loading decoilers that require a specific eye direction. Additionally, interlocks can be programmed with the station equipment so that the car cannot move while a coil is being transferred, enhancing safety and preventing misalignment. These options are not standard and must be specified based on the coil characteristics and station requirements.

Safety standards and risk assessment

Equipment that conveys unit loads such as steel coils falls under the scope of EN 619. The risk assessment for the coil car itself is conducted according to ISO 12100. Where the car feeds a wrapping machine, EN 415-10 covers the wrapper. It is important to note that these standards are design references and methods for risk assessment; they do not constitute a certificate of compliance for the delivered machine. Certification of a delivered machine is confirmed in the project ordering agreement.

The primary hazards include a heavy load moving at floor level, crush points at the track ends and during transfer, and the risk of a coil rolling off. These risks are mitigated through marked travel zones, mechanical end stops, clamping arms, and a guarded control platform. The specific safety features must be tailored to the site conditions and confirmed per project.

Engineering FAQ

Does the coil car replace the overhead crane?

No. The overhead crane is still required to bring coils to the loading point. The coil car handles the precise moves into the stations.

What determines the lift stroke?

The lift stroke is determined by the smallest coil diameter and the center height of the destination station, plus a fixed clearance for bore clearance.

Can one car serve two stations?

It is possible, but using two cars is often recommended to allow independent feeding and higher throughput.

What information is needed for a quote?

To provide an accurate configuration, the supplier requires the coil OD and ID range, coil width and weight, station center heights, track length, and target cycle time.

Next step

A coil car is quoted from the layout, not from a catalogue rating. The enquiry pack carries three groups of data:

  1. Coil specifications: Minimum and maximum Outer Diameter (OD), Inner Diameter (ID), width, and weight.
  2. Station layout: Center heights of the loading and unloading stations, and the distance between them.
  3. Operational requirements: Target cycle time and any specific options needed (e.g., turntable, wear-resistant lining).
  4. Those three groups fix the stroke, the capacity class and the option list. Anything left open comes back as a question list before a drawing is issued. We reply with a proposal after we confirm the details.
